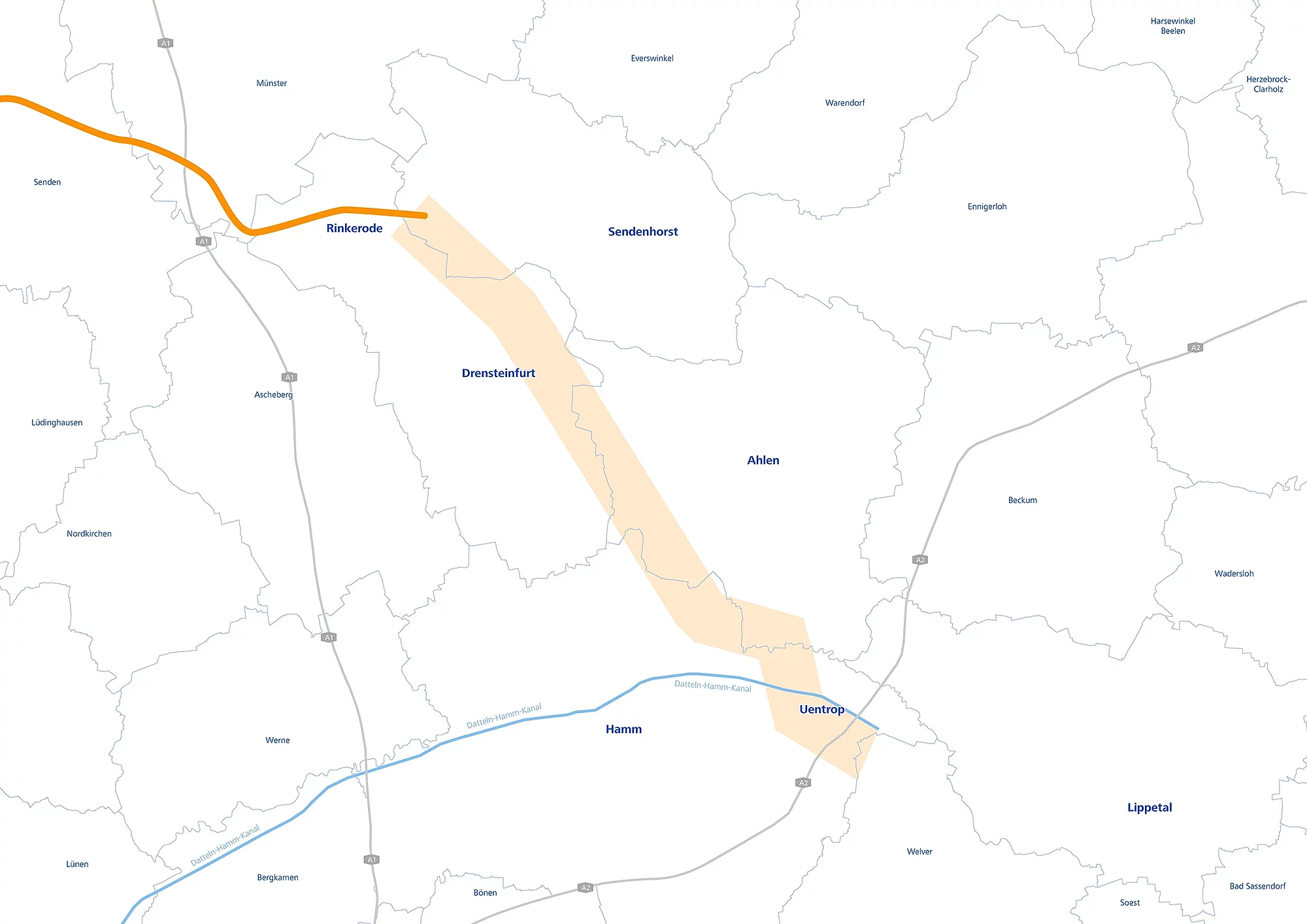

#H2RinkerodeHamm

Hydrogen pipeline
Rinkerode-Hamm(Uentrop)

Hydrogen for the Münsterland and Westphalia

By building the new 30-kilometre hydrogen pipeline between Rinkerode (Drensteinfurt) and Hamm-Uentrop, we are creating the basis for an efficient H2 network in the region. We are establishing the connection to the Germany-wide H2 core network via the neighbouring project, the Coesfeld-Rinkerode H2 pipeline, and in the future via further pipelines in the Hamm area.

This gives local authorities, SMEs and industry in the region an H2 supply perspective and thus an important locational advantage.

We are currently analysing the project area and working on the development of a route corridor. At the same time, we are preparing the start of the authorisation procedure.

Icon einer Route zwischen zwei Standorten als Symbol für die Thyssengas Biogas-Netzkarte.

According to the current planning status, the following municipalities are in the catchment area of the new H2 construction project or border on it:

  • District of Warendorf, town of Drensteinfurt, town of Sendenhorst
  • City of Hamm
Icon eines Baggers als Symbol für den Projekttyp "Neubau einer H2-Leitung".

Project type:

New construction of an H2 pipeline

Icon eines Strategieplans als Symbol für die Projektphase "Planung & vorbereitende Maßnahmen".

Project phase:

Planning & corridor development

Icon mit Zielflaggen als Symbol für die geplante Inbetriebnahme des H2-Projekts.

Planned Commissioning:

End of 2029

Icon einer Wegstrecke als Symbol für die Leitungslänge.

cable length:

around 30 kilometres

Icon eines Winkelmaßes als Symbol für den Leitungsdurchmesser.

Cable diameter:

DN 300 (30 cm)

Icon eines Schildes zwischen zwei Linien als Symbol für den Schutzstreifen.

Protective strip:

3 m on both sides of the cable

Our project plan (planning status Q2/2025)

2024

  • Preliminary discussions with competent authorities
  • Development of route corridors

2025-2027

  • Preparation & implementation of the authorisation procedures
  • Stakeholder discussions & local dialogue markets

2027-2028

  • Finalisation of the approval procedures
  • Stakeholder discussions & local information events
  • Start of construction measures with accompanying communication

End of 2029

  • Technical acceptance & commissioning
  • Start of the recultivation work

The project Q&A

The construction of a new H2 pipeline involves temporary construction work. Unfortunately, construction site noise and traffic restrictions cannot be completely avoided at this time. Dialogue and exchange with the residents of affected communities are an elementary component of all construction projects for us, which is why we provide information on the current status of the project at regular intervals from the early planning phase onwards. Once recultivation has been completed, only individual fittings can be seen along the route of the pipeline and our colleagues are regularly on site for maintenance, otherwise the pipeline is no longer visible.

With our H2 pipeline network, we are connecting the region to the future hydrogen motorways in Germany. Municipalities, industry and SMEs thus gain an H2 supply perspective and the opportunity to organise energy-intensive processes sustainably with the help of hydrogen.

Interested municipalities and companies can use our contact form to report their requirements for hydrogen feed-in or feed-out at any time. We will then check the possibility of a connection to our H2 infrastructure.

Municipalities also play a central role in our project beyond the H2 supply. After all, they are important partners for the successful realisation of the project. This is why we seek dialogue shortly after the start of the project in order to develop the best solution together with local stakeholders and those affected.

The search for the optimal route for a power line takes place in several steps. Firstly, route corridors approximately 600 metres wide are developed based on an analysis of the area (based on geodata, land use data, aerial photographs, inspections, etc.). These corridors are then the subject of the spatial impact assessment, at the end of which the competent authority determines the most suitable corridor in an expert opinion.

Various route options are then developed - i.e. different routes that a new H2 pipeline could take within the corridor. In addition to the operational requirements, an initial assessment of the interactions with protected assets (e.g. animals, landscape, water bodies) takes centre stage. A so-called preferred option with an approx. 80 metre wide route corridor is then created by weighing up the various options. As part of the planning approval procedure, the responsible authority then decides whether to approve or modify the route.

Once all the necessary authorisations have been obtained and the affected parties have been informed, the preparatory measures for construction begin (e.g. route clearance). The next step is the creation of the construction strip along the route (width: approx. 40 metres) and the excavation of the pipeline trench. We take particular care to separate the soil types precisely so that the areas can be recultivated once the construction work is complete.

Various methods can be used when laying the pipes, depending on the project, terrain and soil. The pipeline is then covered with at least one metre of soil. Once the construction work is complete, all that remains of the approx. 40 metre wide construction strip is the two to six metre wide protective strip to the right and left of the pipeline, which must remain freely accessible for maintenance.

At the same time as the technical acceptance, the recultivation of the areas affected will begin.

The spatial impact assessment (RaumVP) analyses whether the implementation of a construction project is compatible with the impact on the surrounding area. Interdisciplinary reports are prepared and possible impacts or conflicts between the project and protected assets (e.g. animals, climate, soil and water) are assessed. Possible alternative locations and routes are also analysed. The spatial impact assessment is carried out with the involvement of the public and the relevant authorities. The result of the spatial impact assessment forms part of the subsequent planning approval procedure, in which a decision is then taken on whether to approve or reject the project.

The planning approval procedure (PFV) is an authorisation procedure for pipeline construction projects. In addition to examining the environmental impact of a project, an essential part of the planning approval procedure is the participation of the affected public. After weighing up all the concerns and objections submitted during the procedure, the authority decides whether the construction and operation of a gas pipeline will be authorised. The district governments in North Rhine-Westphalia and the State Office for Mining, Energy and Geology in Lower Saxony are responsible for carrying out the PIA for gas pipeline construction projects, including public participation.

For us, proactive information and dialogue are an integral part of all pipeline construction projects. From the early planning phase onwards, we inform all those affected about the current status of the project at regular intervals - for example via press releases and on our website. Our on-site dialogue and information events also offer the opportunity to enter into a direct exchange with us and ask questions about the project.

No, the transport of hydrogen via pipelines is a proven and safe technology. The same high safety standards apply to H2 pipelines as to natural gas pipelines. Thyssengas has over 100 years of experience in gas transport and is continuously developing proven control and maintenance processes. Safety is always our top priority - this applies to the construction, operation and maintenance of our pipelines.

Whether natural gas or hydrogen. Our pipelines are monitored 365 days a year. The experts in the network control centres are on duty around the clock, checking the pipelines, organising maintenance and coordinating construction measures in the catchment area of our pipeline network. Regular inspections and aerial surveys of the routes ensure additional safety.

No, the transport of hydrogen via pipelines is a proven and safe technology. For a conversion, the strict regulations of the Energy Industry Act and the Ordinance on High-Pressure Gas Pipelines must be complied with. The same high safety standards apply to H2 pipelines as to natural gas pipelines.

Each pipeline is checked in advance by an independent expert to ensure that it is suitable for hydrogen. Specific measures are defined that must be implemented before a pipeline is converted and are reviewed by an expert before the pipeline is commissioned.

For the construction of the pipeline, a construction strip up to 40 metres wide will be created along the route. The measures required for this, such as earthworks and tree felling, are part of the approval process in advance. Once the work has been completed, the construction strip will be recultivated. A protective strip between two and six metres wide will remain to the right and left of the pipeline, but this can be used for agricultural purposes without any restrictions.

During the construction work, the areas affected by the construction work cannot be used for agricultural purposes. Any damage incurred (e.g. crop failure) will of course be reimbursed. After recultivation, normal agricultural use can be resumed immediately. The permissible cultivation depth of the field / field in the protective strip to the right and left of the pipeline is generally up to 60 centimetres.

Authorisation for the construction of a pipeline is granted as part of the planning approval procedure (PFV). The district governments in North Rhine-Westphalia and the State Office for Mining, Energy and Geology in Lower Saxony are responsible for carrying out the planning approval procedure for gas pipeline construction projects, including public participation.
For pipelines with a diameter of more than 30 centimetres and with a length relevant to spatial planning, the spatial impact assessment takes place before the planning approval procedure. The respective district governments are responsible for carrying this out.

Blau getöntes Bild: Thyssengas-Mitarbeiter blickt auf Windräder, Symbol für den Transport von Wasserstoff (H2).

Together into the energy future

In our projects, we work together with local stakeholders to find the best solution! We focus on dialogue, transparent information, personal discussions and local events. You can contact the project team at any time by e-mail:

projekte@thyssengas.com

Coesfeld-Rinkerode hydrogen pipeline
Hydrogen for the Münsterland and Westphalia.
Vlieghuis-Ochtrup hydrogen pipeline
In favour of a cross-border hydrogen network.
